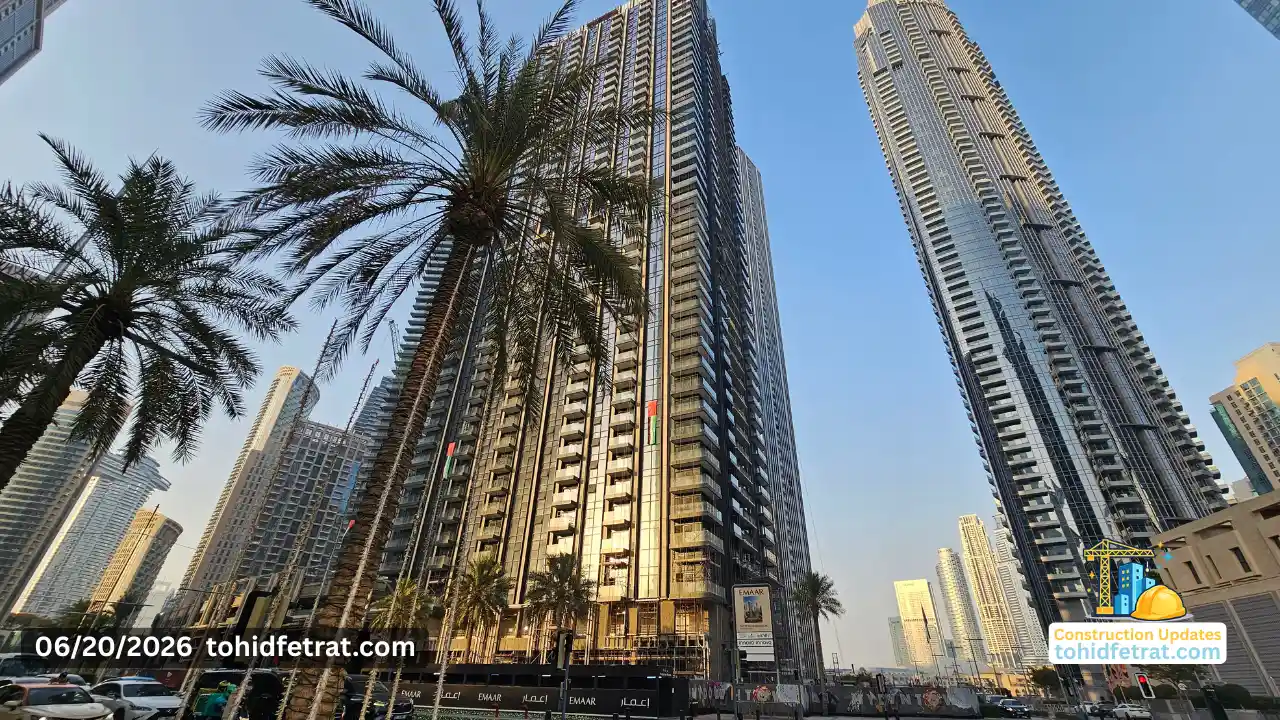

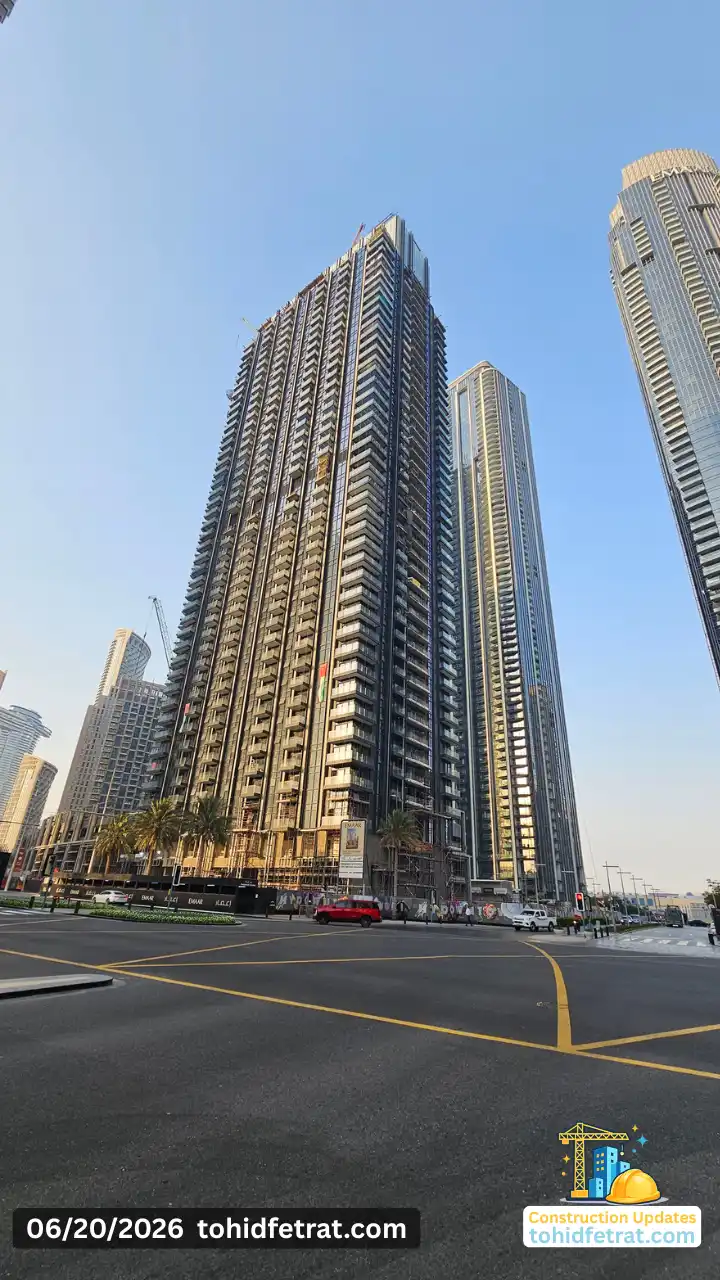

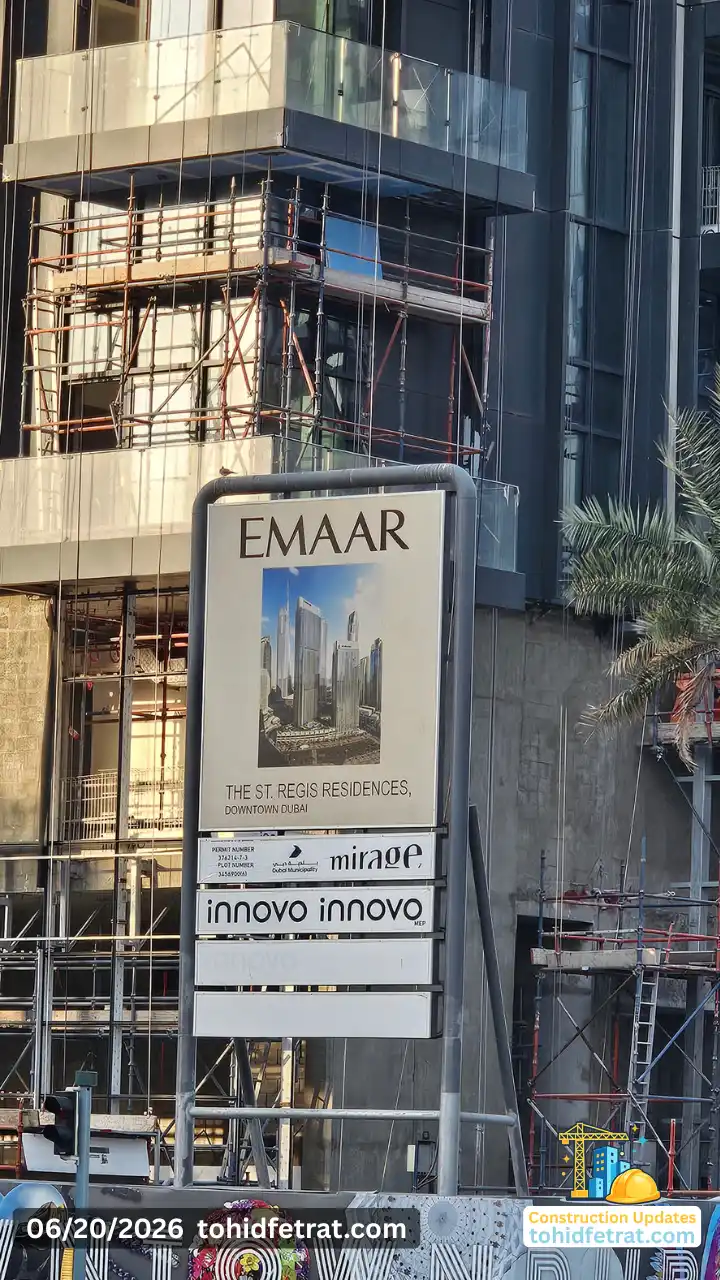

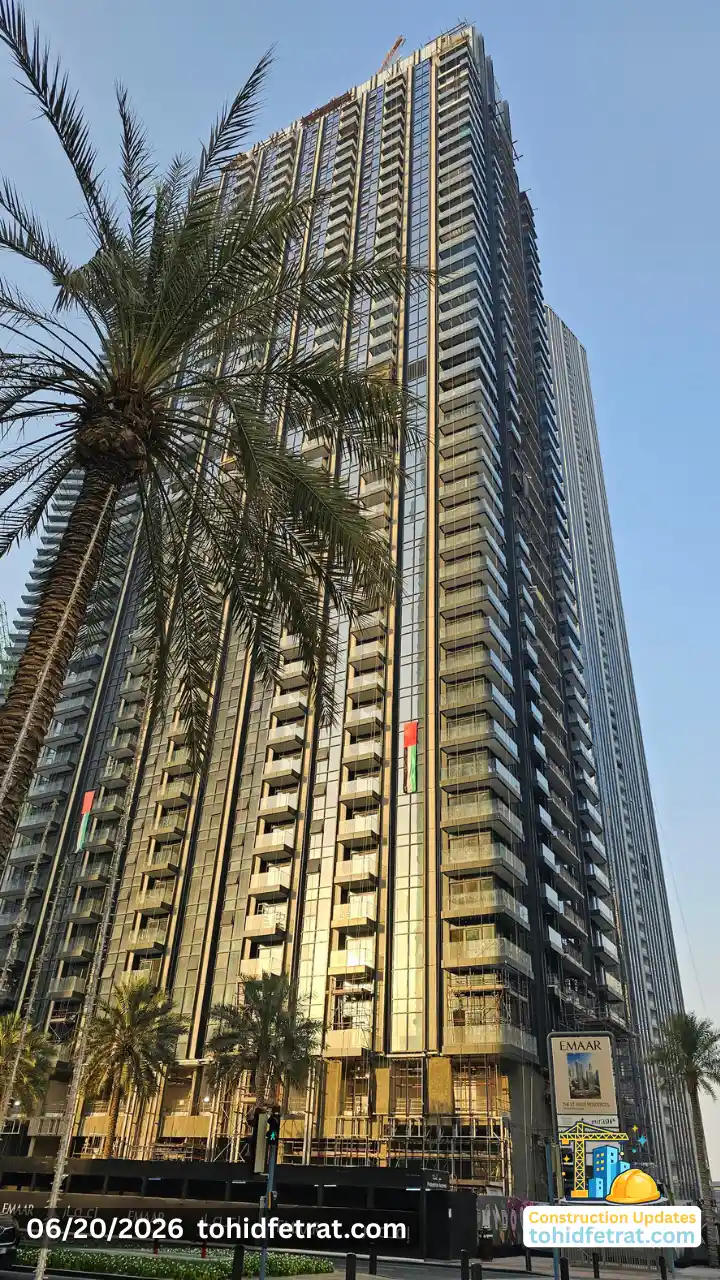

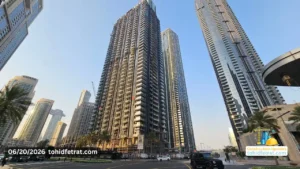

The St. Regis Residences Downtown Dubai construction progress showing high rise residential towers and active site works in 20 June 2026 Dubai Captured by Tohid Fetrat

Emaar Properties · Downtown Dubai

The St. Regis Residences Construction Updates

The Dated Inspection Record of Two Towers Rising in The Opera District

The St. Regis Residences read 76.05% at the 02 June 2026 RERA inspection; superstructure, services, finishes and envelope remain underway as the Opera District towers approach handover.

Construction tracking against RERA inspection data, updated after every recorded inspection.

Direct advisor access. Every message answered personally, never by a call center.

76.05%Construction Progress
02 June 2026Latest RERA Inspection
1,108 residential unitsTotal Units
Project 1816DLD Registration

Construction Snapshot

The St. Regis Residences at a Glance

The St. Regis Residences is Emaar's 1,108-unit pair of towers in The Opera District of Downtown Dubai, 65 and 44 floors plus roof over a shared base of five basements, ground and two podium levels. The DLD register dates the construction start to 28 February 2017, yet the first dated reading in this record, 9.18% on 30 October 2023, found phase 2 still at enabling and piling works, because the inspection report counts those five common basements as a phase 1 delivered long before. That phased start explains why the record opens late and then covers 66.87 points in 946 days, reaching 76.05% on 02 June 2026.

DLD Project Number

1816

Project Status

Active

Construction Start

28 February 2017

Total Units

1,108 residential units

Total Built-Up Area

563,676.34 sq m

Registered Completion Date

25 December 2026 (DLD)

Figures from Dubai Land Department registration records, updated after each recorded inspection. How every project on this site is tracked is explained once on the Dubai Construction Updates hub.

Inspection Record

The St. Regis Residences Construction Update Timeline

Four dated inspections make up this record: 9.18% on 30 October 2023, 40.22% on 10 June 2025, 65.58% on 03 February 2026 and 76.05% on 02 June 2026. Their spacing is uneven, with 589 days between the first two readings against 119 between the last two, so the track below places each reading at its percentage while the table keeps the dates. Each row opens that month's full update with its inspection notes.

Inspection MonthConstruction ProgressInspection DateFull Update
June 202676.05%02 June 2026
February 202665.58%03 February 2026
June 202540.22%10 June 2025
October 20239.18%30 October 2023

Pace Analysis

How Fast The St. Regis Residences Has Been Built

Four dated readings give The St. Regis Residences three measurable intervals, and the rate of climb has differed sharply between them:

  • Oct 2023 to Jun 2025: enabling works into the main contract, 9.18% to 40.22% (31.04 points in 589 days)About 1.6 points per month
  • Jun 2025 to Feb 2026: substructure closed out, superstructure and services rising, 40.22% to 65.58% (25.36 points in 238 days)About 3.2 points per month
  • Feb 2026 to Jun 2026: superstructure, envelope, services and finishes in parallel, 65.58% to 76.05% (10.47 points in 119 days)About 2.6 points per month

This curve starts slow for a reason specific to this site. The first interval, at about 1.58 points a month, straddles a change of contract: the 30 October 2023 report still shows phase 2 at enabling and piling, while on 10 June 2025 mobilisation under the main contract was going on, with foundations and substructure almost complete. With the towers rising, the rate roughly doubled to about 3.20 points a month up to 03 February 2026, then eased to about 2.64 over the 119 days to 02 June 2026, a stretch in which the inspection notes kept every package at the same status. Measured against the registered completion of 25 December 2026, the 23.95 points outstanding at the June reading work out at about 3.49 points a month over 206 days, above the latest measured interval. That is arithmetic on dated readings, not a forecast, and handover is expected in Q4 2026. For an end user the figure to watch is the next dated reading; for an investor, it is the pace of the next interval set against that 3.49.

Get the Next Inspection Figure First

Tell me you are tracking The St. Regis Residences and I will send you the next recorded figure and site photos directly, ahead of the page update.

Get the Next Update on WhatsApp

Project Profile

About The St. Regis Residences at Downtown Dubai

A reading of 76.05% on 02 June 2026 matters most next to what it is building toward. The project guide covers the homes, podium and setting that this record follows:

The St. Regis Residences Downtown Dubai by Emaar twin residential towers beside Burj Khalifa. Presented by Tohid Fetrat.

The St. Regis Residences, Emaar's Branded Downtown Dubai Towers

The St. Regis Residences are a branded Emaar pair of towers in the Opera District, with apartments and four bedroom penthouses.

View the The St. Regis Residences Project Guide

Considering a Near-Handover Entry?

Availability at The St. Regis Residences is listed as limited, and it keeps moving as the towers head toward a Q4 2026 handover. If this record is what brought you here, ask me for current availability before remaining inventory narrows further.

Ask About Remaining Availability on WhatsApp

Stage Record

The St. Regis Residences Build Stages, Mapped to the Inspections

Each stage below is pinned to the inspection window The St. Regis Residences actually occupied, from a 2017 registered start through a basement phase the October 2023 report records as delivered years earlier, so the sequence follows this project's dates rather than a textbook order.

Feb 2017 to Oct 2023, 9.18% at 30 Oct 2023

Phase 1 Basements, Then Phase 2 Enabling

The 30 October 2023 report, at 9.18%, records the five common basements as a phase 1 delivered long before that visit, and phase 2 enabling and piling well advanced.

Oct 2023 to Jun 2025

Main Contract Mobilisation and Substructure

By 10 June 2025 the status had switched to Main Contract - Progressing at 40.22%, with foundations and substructure almost completed and superstructure work in its early stages.

Jun 2025 to Feb 2026

Towers Rising Over a Completed Substructure

The fastest interval in the record: 25.36 points in 238 days, reaching 65.58% on 03 February 2026 with enabling, foundation and substructure works recorded as completed.

Current PhaseFeb 2026 onward, 76.05% at last reading

Envelope, Services and Finishes in Parallel

At 76.05% on 02 June 2026, superstructure, internal works, MEP, internal finishes, external works and the external envelope were all recorded as progressing, each package at its own stage.

Ahead, handover expected Q4 2026

Completion, Snagging and Handover

The 23.95 points left after 02 June 2026 stand between the project and its 25 December 2026 registered completion; buyer inspections and handover, expected in Q4 2026, follow.

What each construction stage involves in general is covered once in the guides on the Dubai Construction Updates hub, so this page stays focused on The St. Regis Residences's own record.

Buyer Position

Tracking Your Position at The St. Regis Residences

This page is one of four project resources that together cover a The St. Regis Residences purchase from payment protection to residency to handover. You are on the construction record; the siblings sit one click away:

The St. Regis Residences Downtown Dubai construction progress showing high rise residential towers and active site works in 20 June 2026 Dubai Captured by Tohid Fetrat
You Are Here

The St. Regis Residences Construction Updates

This page: DLD project 1816 readings, from 9.18% in October 2023 to 76.05% in June 2026.

The St. Regis Residences Golden Visa illustration featuring luxury residential towers in Downtown Dubai alongside a UAE Golden Visa card representing property investment eligibility. Presented by Tohid Fetrat

The St. Regis Residences Golden Visa in The Opera District

The St. Regis Residences, Emaar's 1,108 residences in two Downtown Dubai towers, qualifies at every typology from the 1 bedroom.

Read the The St. Regis Residences Golden Visa Guide
The St. Regis Residences escrow account illustration featuring luxury residential towers with security shield and lock symbols representing protected property investment in Downtown Dubai. Presented by Tohid Fetrat

The St. Regis Residences Escrow: Emaar's Downtown Account at Dubai Islamic Bank

The St. Regis Residences in Downtown Dubai escrows 1108 units at Dubai Islamic Bank, DLD project 1816, 76.05% certified June 2026.

Verify the The St. Regis Residences Escrow Account
The St. Regis Residences Snagging Inspection showing the residential tower on 20 June 2026 in Downtown Dubai Captured by Tohid Fetrat

The St. Regis Residences Snagging in The Opera District

The St. Regis Residences is the pair of Emaar towers of 65 and 44 floors in Downtown Dubai, holding 1,108 residences.

Book The St. Regis Residences Snagging

Approaching Handover

Between 76.05% and Handover: What The St. Regis Residences Buyers Should Do Now

At the 02 June 2026 reading, 23.95 points still separated The St. Regis Residences from 100%, with superstructure, MEP, internal finishes and the envelope all recorded as progressing and handover expected in Q4 2026. Handover notices usually leave buyers only a short window to complete their appointment, so the three steps below belong to the months before the notice, not the week it arrives.

First, plan an independent snagging inspection so defects in your apartment or penthouse are documented before you accept it; The St. Regis Residences snagging guide covers timing and what is checked in a high-rise unit.

Second, every dated instalment in the March 2022 schedule of record fell due by November 2025, so the open row is the 30% on construction completion; before it moves, confirm it is going to the project's escrow account at Dubai Islamic Bank using The St. Regis Residences escrow verification page.

Third, if residency is part of your plan, settle the Golden Visa sequence before the keys, since the title deed timing shapes the application path; The St. Regis Residences Golden Visa residency guide sets out the steps.

Send me your unit number on WhatsApp and I will tell you what the latest inspection means for your handover and map the sequence for your specific unit.

The Wider Picture

Explore Downtown Dubai Structure

Two towers at 76.05% on 02 June 2026 are rising into one of Dubai's most finished districts. These three pages set the build record against the listings, the neighbourhood and the developer around it:

Downtown Dubai Properties for Sale featuring Burj Khalifa, Dubai Mall, Dubai Fountain and the iconic skyline of central Dubai. Presented by Tohid Fetrat

Downtown Dubai Properties for Sale

Browse apartments, branded residences and penthouses for sale around Burj Khalifa and The Dubai Mall.

See Downtown Dubai Properties for Sale
Downtown Dubai skyline at sunset featuring Burj Khalifa and Address Sky View Towers — captured and curated by Tohid Fetrat.

Downtown Dubai Community Overview

Read the Downtown Dubai guide: Emaar's city core around Burj Khalifa, The Dubai Mall and Dubai Opera, with prices and returns.

Explore the Downtown Dubai Community
Emaar Properties developer showcasing Downtown Dubai skyline with Burj Khalifa and surrounding residential and commercial towers at dusk Presented by Tohid Fetrat

Emaar Properties: Burj Khalifa, Downtown Dubai and Twenty Master Communities

Emaar, founded in 1997, built Burj Khalifa and Downtown Dubai and has delivered over 85,000 homes across twenty master communities.

View the Emaar Properties Developer Profile

Construction tracking for other Dubai projects is indexed on the Dubai Construction Updates hub.

FAQs

The St. Regis Residences Construction Updates Frequently Asked Questions

The St. Regis Residences, DLD project 1816, is an active project under construction, recorded at 76.05% at the RERA inspection of 02 June 2026 with the progress report status Main Contract - Progressing. That report lists enabling, foundation and substructure works as completed and six packages, superstructure, internal works, MEP, internal finishes, external works and the external envelope, as progressing, each at its own stage. The full record is in the inspection timeline above.

The 02 June 2026 inspection recorded 76.05%, a gain of 10.47 points on the 65.58% of 03 February 2026 and the fourth dated reading in this record. It is also the first reading above 70%, reached with 16 inspection photographs filed, the most of any visit so far. The notes and figures for that visit are in the St. Regis Residences June 2026 construction update.

Handover is expected in Q4 2026. The DLD register for project 1816, as viewed in September 2026, shows a registered completion date of 25 December 2026, and the developer's payment plan puts estimated construction completion in December 2026. At the 02 June 2026 reading of 76.05%, that registered date was 206 days away and had not passed, and this page's record is updated as each new inspection is recorded.

DLD registration records list 1,108 units for project 1816. The inspection report describes them in two towers, Tower 1 of 65 floors plus roof and Tower 2 of 44 floors plus roof, over a common base of five basements, a ground level and two podium levels, with retail alongside the residences. Homes run from 1 bedroom apartments to 4 bedroom penthouses, and layouts are set out in The St. Regis Residences project guide.

Measured between dated readings on a 30-day month, the pace was about 1.58 points a month from 30 October 2023 (9.18%) to 10 June 2025 (40.22%), about 3.20 from then to 03 February 2026 (65.58%), and about 2.64 from then to 02 June 2026 (76.05%). The 23.95 points left at that last reading, spread over the 206 days to the registered completion of 25 December 2026, come to about 3.49 points a month. That is arithmetic on past readings, not a forecast; the breakdown is in the pace analysis above.

The DLD register gives 28 February 2017 as the construction start, after registration on 03 October 2016. The first dated reading in this record came much later, 9.18% on 30 October 2023, when the inspection report described phase 1, five common basements, as delivered long before and phase 2 as still at enabling and piling works; that visit is covered in the St. Regis Residences October 2023 construction update.

Portrait of Tohid Fetrat, Dubai real estate advisor and portfolio manager with expertise in luxury developments

Your Advisor

Tohid Fetrat

Independent of the developer: I work for the buyer, and my only job on this page is keeping the The St. Regis Residences construction record accurate, inspection by inspection, until handover, walking the site personally each inspection period. Client identities and transactions are never published or referenced. Message or call me directly: you will always reach me personally, never a call center or sales team.
