Emaar Properties · Business Bay
Avarra by Palace Construction Updates
The Inspection Record of a 67-Floor Palace Tower Beside Business Bay Metro
Avarra by Palace recorded 0.08% at its 10 June 2026 RERA inspection, the first reading to find mobilisation under way on plot 141 beside Business Bay Metro.
Construction tracking against RERA inspection data, updated after every recorded inspection.
Direct advisor access. Every message answered personally, never by a call center.
Construction Snapshot
Avarra by Palace at a Glance
Avarra by Palace is Emaar Properties' single Palace-branded tower on plot 141 in Business Bay, planned as 2B + G + 10 Podiums + 67 Floors with 688 residences and 6 ground-floor retail units. The DLD register dates its registration to 20 November 2025 and its construction start to 15 May 2026, and the 0.08% recorded on 10 June 2026 arrived just 26 days after that start. With completion registered for 30 June 2031, this record opens with just over five years of the programme still ahead, so the cards below are register anchors rather than a verdict on progress.
4227
Active
15 May 2026
688 residential units
83,718.31 sq m
30 June 2031 (DLD)
Figures from Dubai Land Department registration records, updated after each recorded inspection. How every project on this site is tracked is explained once on the Dubai Construction Updates hub.
Inspection Record
Avarra by Palace Construction Update Timeline
Two RERA visits make up this record so far: 0% on 18 November 2025, when the report logged no works started on plot 141 and set no progress status, and 0.08% on 10 June 2026, when mobilisation was under way and the status read Enabling Works, Progressing. Both dots sit at the very start of the track below, a spread of 0.08 points across 204 days, and each table row links the monthly update written for that visit.
| Inspection Month | Construction Progress | Inspection Date | Full Update |
|---|---|---|---|
| June 2026 | 0.08% | 10 June 2026 | View the June 2026 update |
| November 2025 | 0% | 18 November 2025 | View the November 2025 update |
Pace Analysis
How Fast Avarra by Palace Has Been Built
With two readings on file, the Avarra by Palace record holds a single interval, and its arithmetic is shown exactly as recorded:
- Nov 2025 to Jun 2026: pre-start baseline to mobilisation, 0% to 0.08%+0.08 points in 204 days
That interval straddles the registered construction start of 15 May 2026: 178 of its 204 days fall before works were recorded as begun, and the June visit came 26 days after that date. Spread across the calendar, a 0.08-point change says more about when the plot was inspected than about how the tower is being built, so this page publishes no monthly rate for it and reads nothing early or late into it. What did change is the stage label, from no status in November 2025 to Enabling Works, Progressing in June 2026. For an investor timing an exit or an end user planning a June 2031 move, the reading to watch is the first to record work beyond enabling, since only then does a monthly rate for this 67-floor tower carry meaning.
Get the Next Inspection Figure First
Tell me you are tracking Avarra by Palace and I will send you the next recorded figure and site photos directly, ahead of the page update.
Get the Next Update on WhatsAppProject Profile
About Avarra by Palace at Business Bay
The 0.08% recorded on 10 June 2026 only makes sense next to the 67-floor tower it is counting toward. The full project guide sets out what this record is tracking:

Avarra by Palace: Emaar's Branded Tower by Business Bay Metro
Avarra by Palace is Emaar's Palace-branded tower in Business Bay, with 688 residences up to a six bedroom penthouse.
View the Avarra by Palace Project GuideConsidering an Entry Before the Structure Rises?
Availability at Avarra by Palace changes as Emaar releases and sells units, so the floors, views, and layouts on offer while the site mobilises may not be there by the next inspection. If this record is what brought you here, ask me what is available today before you choose a tier.
Ask About Remaining Availability on WhatsAppStage Record
Avarra by Palace Build Stages, Mapped to the Inspections
Each stage below is pinned to the window it occupies in the project 4227 record. Two stages already carry inspection dates; the three that follow are shown against the construction-linked milestones in Emaar's launch payment plan, which are estimates, not recorded progress.
Registration and Baseline Inspection
The 18 November 2025 inspection logged plot 141 at 0% with no progress status, and the DLD register dates the project's registration to 20 November 2025.
Mobilisation and Enabling Works

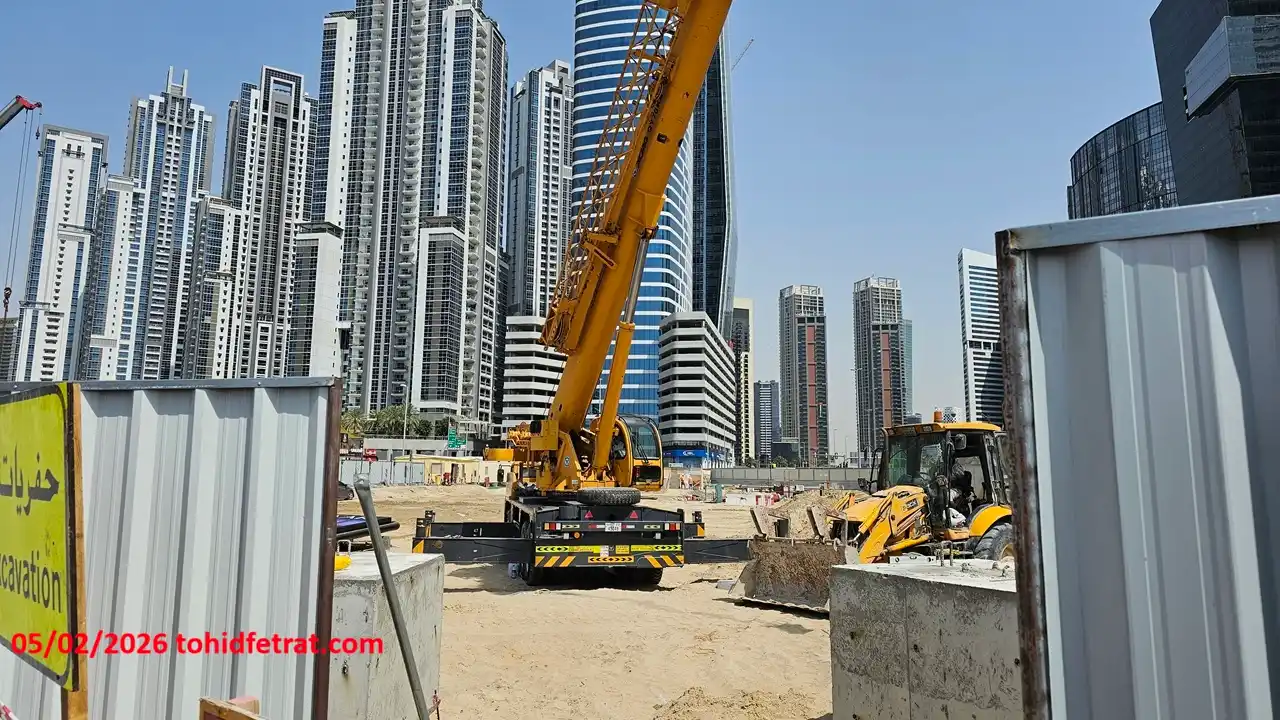

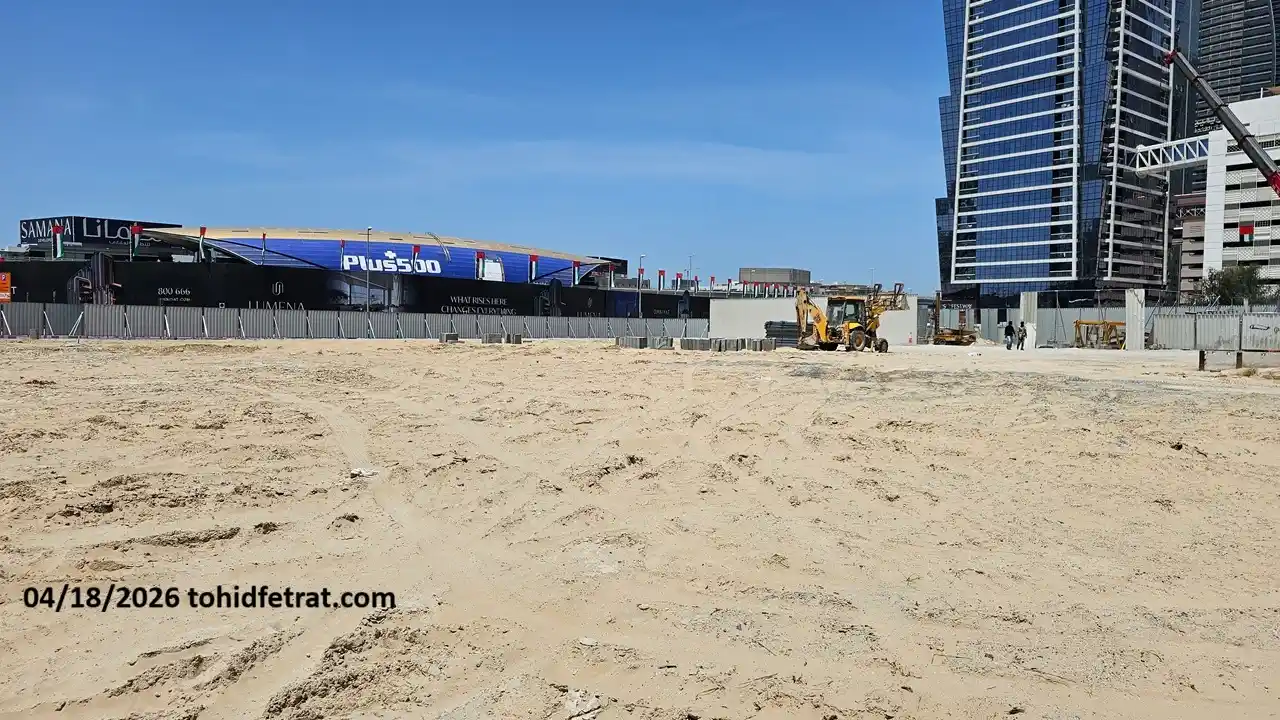

Construction start is registered for 15 May 2026, and the 10 June 2026 inspection recorded 0.08% with mobilisation under way and the status Enabling Works, Progressing.
Basements, Podiums, and Tower Rise
No inspection has reached this stage. It spans the two basements, ten podium levels, and 67 floors; the launch plan ties its 8th instalment to 50% completion, estimated for March 2029.
Facade, Fit-Out, and Amenity Levels
Unrecorded so far. The glass facades, apartment interiors, infinity pool deck, and fitness areas belong here, with 70% completion estimated for September 2029 and 90% for April 2030 in the launch plan.
Completion and Handover
The DLD register sets completion for 30 June 2031, matching the June 2031 handover and the final 10% instalment that the launch plan links to 100% completion.
What each construction stage involves in general is covered once in the guides on the Dubai Construction Updates hub, so this page stays focused on Avarra by Palace's own record.
Buyer Position
Tracking Your Position at Avarra by Palace
This page is one of four project resources that together cover a Avarra by Palace purchase from payment protection to residency to handover. You are on the construction record; the siblings sit one click away:

Avarra by Palace Construction Updates
This page: every RERA reading for project 4227, from the 0% baseline to June 2031 handover.

Avarra by Palace Golden Visa Through Any Apartment in the Tower
Avarra by Palace, Emaar's Palace-branded Business Bay tower of 688 units, qualifies at all four apartment types, 1 to 4 bedrooms.
Read the Avarra by Palace Golden Visa Guide
Avarra by Palace: The Business Bay Escrow at Emirates NBD
Emaar's Avarra by Palace in Business Bay escrows 694 units at Emirates NBD as DLD project 4227, 0.08% certified June 2026.
Verify the Avarra by Palace Escrow AccountApproaching Handover
Between 0.08% and Handover: What Avarra by Palace Buyers Should Do Now
At 0.08% on 10 June 2026 the tower has no recorded structure, and the first construction-linked instalment in Emaar's launch plan waits for 50% completion, estimated for March 2029. Until then the launch schedule of record keeps calendar-dated instalments running, with 5% dated November 2026 and 10% dated April 2027, so the three steps below are worth settling before the next dated payment rather than after it.
First, confirm that each dated instalment reaches the Emirates NBD trust account for project 4227; the Avarra by Palace escrow account record sets out how to check it before you transfer.
Second, follow the inspection record rather than the launch materials: the Avarra by Palace June 2026 update documents the first enabling-works reading, and each later monthly update joins the timeline above.
Third, if residency is part of your plan, review eligibility early through the Avarra by Palace Golden Visa eligibility guide, since all four priced apartment types start at AED 2.70M ≈ USD 735K or more.
Send me your unit number on WhatsApp and I will tell you what the latest inspection means for your handover and map the sequence for your specific unit.
The Wider Picture
Explore Business Bay Structure
A build record is only half the picture; the other half is the district a 67-floor tower is joining. These three pages set the Avarra by Palace record in its market, community, and developer context:

Business Bay Properties for Sale
Browse canal-front apartments, penthouses and branded residences for sale across Business Bay.
See Business Bay Properties for Sale
Business Bay Community Overview
Read the Business Bay guide: canal-front towers, offices and residences minutes from Downtown, with prices and rental demand covered.
Explore the Business Bay Community
Emaar Properties: Burj Khalifa, Downtown Dubai and Twenty Master Communities
Emaar, founded in 1997, built Burj Khalifa and Downtown Dubai and has delivered over 85,000 homes across twenty master communities.
View the Emaar Properties Developer ProfileConstruction tracking for other Dubai projects is indexed on the Dubai Construction Updates hub.
FAQs
Avarra by Palace Construction Updates Frequently Asked Questions
Avarra by Palace is an Active DLD-registered project, number 4227, in its enabling works stage, recorded at 0.08% at the RERA inspection of 10 June 2026 with the status Enabling Works, Progressing. The full record is in the inspection timeline above.
The 10 June 2026 inspection recorded 0.08% construction progress, up 0.08 points from the 0% reading of 18 November 2025, and noted mobilisation under way on plot 141. That visit is covered in the Avarra by Palace June 2026 construction update.
The DLD register sets the completion date for project 4227 at 30 June 2031, which agrees with the June 2031 handover and with the launch payment plan's final 10% instalment, linked to 100% completion that same month. At the 10 June 2026 inspection the project stood at 0.08%. Register dates can be revised between inspection cycles, and this page's record is updated as each new inspection is recorded.
Avarra by Palace includes 688 residential units, per the RERA inspection reports for project 4227, in a tower configured as 2B + G + 10 Podiums + 67 Floors with 6 retail units at ground floor. The priced mix runs from 1-bedroom to 4-bedroom apartments, alongside a six-bedroom penthouse.
The DLD register dates the construction start to 15 May 2026. The first tracked inspection came earlier, on 18 November 2025, and recorded 0%, two days before the project's 20 November 2025 registration; that baseline is documented in the Avarra by Palace November 2025 construction update.
As of the 10 June 2026 inspection, no structure is recorded at Avarra by Palace: the report places the site in mobilisation at 0.08%, with the status Enabling Works, Progressing, after the 18 November 2025 report recorded 0% and no works started. The stage-by-stage view is in the stage record above.

Your Advisor
Tohid Fetrat
Independent of the developer: I work for the buyer, and my only job on this page is keeping the Avarra by Palace construction record accurate, inspection by inspection, until handover, walking the site personally each inspection period. Client identities and transactions are never published or referenced. Message or call me directly: you will always reach me personally, never a call center or sales team.
Ask your question, get your answer. No obligation and no follow-up unless you ask for it.
