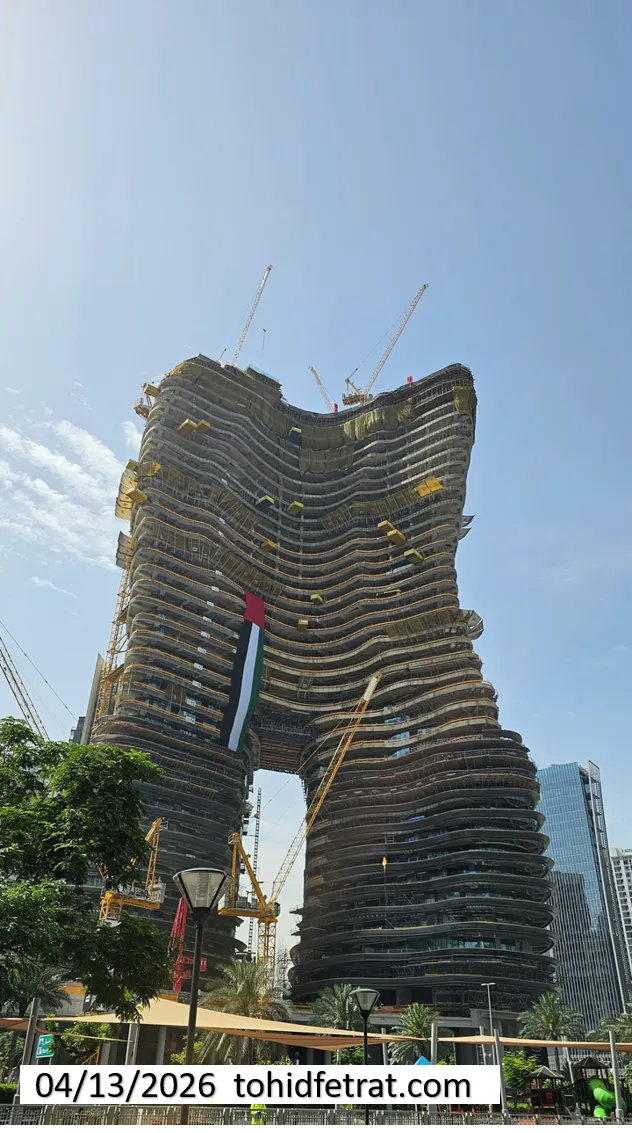

Bugatti Residences Construction Updates showing the tower under construction on 9 April 2026 in Business Bay Dubai Captured by Tohid Fetrat

Binghatti · Business Bay

Bugatti Residences Construction Updates

Four Dated Readings, One Branded Tower Rising on Business Bay Plot 83

Bugatti Residences stood at 65.57% in the DLD register at the 23 September 2026 inspection, a climb from a bare Business Bay plot to an advanced-stage tower.

Construction tracking against RERA inspection data, updated after every recorded inspection.

Direct advisor access. Every message answered personally, never by a call center.

65.57%Construction Progress
23 September 2026Latest RERA Inspection
184 ResidencesTotal Units
Project 2547DLD Registration

Construction Snapshot

Bugatti Residences at a Glance

Bugatti Residences is Binghatti's single branded tower of 184 Residences in Business Bay, held in the Dubai Land Department register as project 2547 on plot 83. The register dates the construction start to 01 March 2023 and the first inspection to 18 May 2023, when the plot was logged at 0%; that inspection sits six days before the 24 May 2023 registration recorded in the same register. From that empty plot the record reached 65.57% on 23 September 2026, with the handover expected in Q4 2026; the anchors behind those figures are below.

DLD Project Number

2547

Project Status

Active

Construction Start

01 March 2023

Total Units

184 Residences

Total Built-Up Area

90,065.40 sq m

Registered Completion Date

31 December 2025 (DLD)

Figures from Dubai Land Department registration records, updated after each recorded inspection. How every project on this site is tracked is explained once on the Dubai Construction Updates hub.

Inspection Record

Bugatti Residences Construction Update Timeline

Four dated readings make up the Bugatti Residences record: 0% at the 18 May 2023 baseline, 20.04% on 06 December 2024, 52.29% on 20 January 2026 and 65.57% on 23 September 2026. The intervals between them run 568, 410 and 246 days, so the spacing of the dots on the track below reflects the inspection calendar as much as the build, and each table row opens that visit's full monthly update.

Inspection MonthConstruction ProgressInspection DateFull Update
September 202665.57%23 September 2026View the September 2026 update
January 202652.29%20 January 2026View the January 2026 update
December 202420.04%06 December 2024View the December 2024 update
May 20230%18 May 2023View the May 2023 update
!

Reading the dates: the DLD register still carries 31 December 2025 as the registered completion date for project 2547, and the 65.57% reading of 23 September 2026 was logged 266 days after it. That entry is a register field, not a handover notice: Bugatti Residences is expected to hand over in Q4 2026, and the handover itself is set by Binghatti under each buyer's SPA.

Pace Analysis

How Fast Bugatti Residences Has Been Built

Measured between dated readings on a 30-day month, the Bugatti Residences record splits into three stretches with clearly different speeds, plus one average across the whole series. Every figure is arithmetic on the DLD register, not a forecast:

  • May 2023 to Dec 2024: mobilisation, enabling and foundations, 0% to 20.04%About 1.06 points per month
  • Dec 2024 to Jan 2026: tower structure, 20.04% to 52.29%About 2.36 points per month
  • Jan 2026 to Sep 2026: envelope, MEP and external works, 52.29% to 65.57%About 1.62 points per month
  • May 2023 to Sep 2026: whole series over 1,224 days, 0% to 65.57%About 1.61 points per month

The curve opens flat for a reason the first report states directly: the 18 May 2023 inspection logged no works under way on plot 83, so the first 568 days carry mobilisation, enabling and foundation works, which add few points for the time they take. The 410 days to 20 January 2026 are the steepest part of the record, 32.25 points while the curved structure climbed and the envelope, MEP and finishing packages first entered the notes. Since then the rate has eased to about 1.62 a month, a stretch in which the 23 September 2026 report describes the structure at an advanced stage and adds external works to four packages already running in parallel. Two further recorded facts sit beside that curve: 34.43 points separated the register from 100% at the September 2026 reading, and the expected Q4 2026 handover quarter ends 99 days after it, on 31 December 2026. For an end user, that pairing makes the next dated reading more informative than the calendar; for an investor, the 2025 stretch shows what this site delivered while structure was the main task, and the next pair will show how the finishing phase compares. None of these figures predicts the handover date.

Get the Next Inspection Figure First

Tell me you are tracking Bugatti Residences and I will send you the next recorded figure and site photos directly, ahead of the page update.

Get the Next Update on WhatsApp

Project Profile

About Bugatti Residences at Business Bay

A register percentage reads better next to what is actually being built. The project guide covers the residences this record is tracking toward:

Aerial view of Bugatti Residences by Binghatti in Business Bay Dubai, showcasing fluid rooftop architecture with luxury swimming pools and sculptural design. Presented by Tohid Fetrat.

Bugatti Residences: Binghatti's Branded Canal-Side Tower in Business Bay

Binghatti's Bugatti Residences on the Business Bay canal side offers Riviera Mansion residences with private pools and Sky Mansion Penthouses.

View the Bugatti Residences Project Guide

Considering a Late-Stage Entry?

Bugatti Residences is listed with limited availability while the record stands at 65.57%, and what remains can change between readings. If this record is what brought you here, ask me what is available now, before the expected Q4 2026 handover.

Ask About Remaining Availability on WhatsApp

Stage Record

Bugatti Residences Build Stages, Mapped to the Inspections

Each stage below is pinned to the inspection window it occupied in the Bugatti Residences record, from the 0% baseline on plot 83 in May 2023 to the 65.57% reading of 23 September 2026, with the last stage still ahead of the Q4 2026 handover.

Mar 2023 to May 2023

Start, Baseline and Registration

The register dates the start to 01 March 2023; the 18 May 2023 inspection logged 0% with the status Not Started, and registration followed on 24 May 2023.

May 2023 to Dec 2024

Mobilisation, Enabling and Foundations

By 06 December 2024 the main contractor was appointed and mobilising, enabling and foundation works were reported complete, and the register read 20.04%.

Dec 2024 to Jan 2026

Curved Tower Structure

The steepest stretch: 32.25 points in 410 days as structure works advanced, reaching 52.29% on 20 January 2026 with envelope, MEP and interior finishes already in progress.

Current PhaseJan 2026 onward, 65.57% at last reading

Envelope, Services and External Works

On 23 September 2026 the structure was reported at an advanced stage, with envelope, MEP, internal finishes and external works progressing together at 65.57%.

Ahead of the Q4 2026 handover

Finishing, Completion Checks and Handover

The 34.43 points left after the 23 September 2026 reading cover the remaining packages and completion inspections before handover of the 184 Residences.

What each construction stage involves in general is covered once in the guides on the Dubai Construction Updates hub, so this page stays focused on Bugatti Residences's own record.

Buyer Position

Tracking Your Position at Bugatti Residences

This page is one of four project resources that together cover a Bugatti Residences purchase from payment protection to residency to handover. You are on the construction record; the siblings sit one click away:

Bugatti Residences construction update showing structural progress with cranes and tower development in Business Bay Dubai Presented by Tohid Fetrat
You Are Here

Bugatti Residences Construction Updates

This page: four Bugatti Residences register readings, 0% in May 2023 to 65.57% in September 2026.

Bugatti Residences Golden Visa concept with documents and luxury architecture view in Business Bay Dubai Presented by Tohid Fetrat

Bugatti Residences Golden Visa: Four Tiers Nearly Ten Times Over

Bugatti Residences is Binghatti's freehold Business Bay tower, and all four tiers clear the AED 2M line by a wide margin.

Read the Bugatti Residences Golden Visa Guide
Bugatti Residences escrow account luxury entrance architecture with drop off area in Business Bay Dubai Presented by Tohid Fetrat

Bugatti Residences Escrow Account: Binghatti's Business Bay Tower

Payments for Bugatti Residences go to Sharjah Islamic Bank escrow under DLD project 2547; 191 units, 65.57% certified in September 2026.

Verify the Bugatti Residences Escrow Account
Bugatti by Binghatti construction update in April 2026 showing colorful visual marketing display panel with vibrant graphics and illuminated elements in Dubai - Captured by Tohid Fetrat

Bugatti Residences Snagging: Private-Pool Mansions in a Branded Tower

Bugatti Residences is Binghatti's Bugatti-branded Business Bay tower of 184 residences; the pre-handover inspection covers each private-pool home.

Book Bugatti Residences Snagging

Approaching Handover

Between 65.57% and Handover: What Bugatti Residences Buyers Should Do Now

At 65.57% on 23 September 2026, Bugatti Residences is past the steepest part of its curve but still short of the finishing band, so the work for buyers is keeping payments matched to the record and following each reading as it lands. The expected handover quarter, Q4 2026, opened eight days after that inspection, and handover notices usually leave a short window to act, so the three steps below start before any notice arrives.

First, keep every remaining installment, including the 30% handover share under the indicative 20/50/30 plan, subject to confirmation in the Binghatti SPA, tied to the register: the Bugatti Residences escrow account record for project 2547 shows where those payments belong.

Second, follow the record one reading at a time: the September 2026 Bugatti Residences construction update holds the latest visit in full, and this page gains a new row when the next reading is logged in the DLD register.

Third, put the pre-handover inspection on your calendar now, even with finishes still progressing; the Bugatti Residences snagging inspection guide explains the timing and the branded-residence features worth checking.

Send me your unit number on WhatsApp and I will tell you what the latest inspection means for your handover and map the sequence for your specific unit.

The Wider Picture

Explore Business Bay Structure

A tower at 65.57% is finishing into a district already built around it. These three pages set the Bugatti Residences record against the Business Bay market, the community and Binghatti itself:

Business Bay properties for sale featuring modern residential towers and premium Dubai skyline views Captured by Tohid Fetrat.

Business Bay Properties for Sale

Browse canal-front apartments, penthouses and branded residences for sale across Business Bay.

See Business Bay Properties for Sale
Business Bay skyline view featuring Opus Tower Bugatti Residences by Binghatti The Binary by Omniyat and Ahad Tower with modern high rise architecture and urban city streets captured by Tohid Fetrat.

Business Bay Community Overview

Read the Business Bay guide: canal-front towers, offices and residences minutes from Downtown, with prices and rental demand covered.

Explore the Business Bay Community
Binghatti luxury towers in Dubai – Bugatti Residences, Mercedes-Benz Places, and Skyblade by Binghatti, representing iconic branded architecture and innovation, presented by Tohid Fetrat.

Binghatti: Record Construction Speed and Branded Towers With Bugatti and Mercedes-Benz

Binghatti has delivered more than 60 projects since 2008, with 27 under development and two master communities across Dubai.

View the Binghatti Developer Profile

Construction tracking for other Dubai projects is indexed on the Dubai Construction Updates hub.

FAQs

Bugatti Residences Construction Updates Frequently Asked Questions

Bugatti Residences is an active project in the DLD register (number 2547), read at 65.57% on the 23 September 2026 inspection. The RERA report of that date records the status as Main Contract - Progressing, with enabling, piling and foundation works complete and the structure at an advanced stage, which places the tower in its envelope, services and external works phase, as mapped in the stage record above.

Four dated readings, all taken from the DLD project register: 0% on 18 May 2023, 20.04% on 06 December 2024, 52.29% on 20 January 2026 and 65.57% on 23 September 2026. The latest added 13.28 points to the January 2026 figure, after rises of 20.04 and 32.25 points across the two earlier intervals. The newest visit is covered on the Bugatti Residences September 2026 inspection page.

The interval from 06 December 2024 to 20 January 2026, when the register rose 32.25 points in 410 days, about 2.36 points per 30-day month, well above the 1.06 a month logged between May 2023 and December 2024, the 1.62 a month between January and September 2026, and the whole-series average across 1,224 days, about 1.61 a month. All four figures are arithmetic on dated readings, not a forecast; the breakdown sits in the pace analysis.

The Independent Progress Monitoring Report for project 2547 records an inspection date, a progress status and written site notes, but on all four visits it prints no percentage figure. Every percentage on this page therefore comes from the DLD project register, which holds the reading for each inspection date, while the report supplies the status: Not Started on 18 May 2023 and Main Contract - Progressing from 06 December 2024 onward.

No. The DLD register lists 31 December 2025 as the registered completion date for project 2547, and that date had passed 266 days before the 65.57% reading of 23 September 2026. Bugatti Residences is expected to hand over in Q4 2026; the register entry is an administrative field, handover timing is set by Binghatti under each buyer's SPA, and this page's record is updated when the closing inspection is recorded.

Bugatti Residences comprises 184 Residences in a single tower configured as 4B + G + 1P + HC + 45 + Roof: four basements, a ground level, one podium, a health club floor, 45 storeys and the roof level. The developer factsheet gives 43 residential floors and a building height of 200 m, and the same configuration line appears in all four RERA reports between May 2023 and September 2026.

Portrait of Tohid Fetrat, Dubai real estate advisor and portfolio manager with expertise in luxury developments

Your Advisor

Tohid Fetrat

Independent of the developer: I work for the buyer, and my only job on this page is keeping the Bugatti Residences construction record accurate, inspection by inspection, until handover, walking the site personally each inspection period. Client identities and transactions are never published or referenced. Message or call me directly: you will always reach me personally, never a call center or sales team.

Ask your question, get your answer. No obligation and no follow-up unless you ask for it.

WhatsApp +971543443597
Get the Latest Status
