Emaar · Dubai Hills Estate
Golf Hillside Construction Updates
The Verified Build Record Beside the Dubai Hills Golf Course
Golf Hillside reached 54.66% construction at its 21 April 2026 RERA inspection, its superstructure now rising floor by floor through the twenty storey Dubai Hills Estate tower.
Construction tracking against RERA inspection data, updated after every recorded inspection.
Direct advisor access. Every message answered personally, never by a call center.
Construction Snapshot
Golf Hillside at a Glance
Golf Hillside is Emaar's 184-residence tower rising on plot 5366 in the golf district of Dubai Hills Estate, oriented toward the Dubai Hills Golf Course. Just over eighteen months separate its 16 October 2024 construction start from the 54.66% recorded at the April 2026 inspection, and the figures below are the DLD-registered anchors behind that record. Because this is a single twenty storey tower rather than a multi-plot phase, its inspection curve reads as one clean structural climb, not a blended average across several buildings.
3237
Active
16 October 2024
184 residential units
20,017.71 sq m
31 December 2028 (DLD)
Figures from Dubai Land Department registration records, updated after each recorded inspection. How every project on this site is tracked is explained once on the Dubai Construction Updates hub.
Inspection Record
Golf Hillside Construction Update Timeline
Two dated RERA inspections anchor this record so far: 36.65% on 5 January 2026 and 54.66% on 21 April 2026, an 18.01 point climb in a single cycle. An earlier register reading of 23.97% preceded the January figure, but it carries no published inspection date, so it sits in this narrative rather than as a dot on the dated track below. Each table row links the full monthly update with site photographs.
| Inspection Month | Construction Progress | Inspection Date | Full Update |
|---|---|---|---|
| April 2026 | 54.66% | 21 April 2026 | View the April 2026 update |
| January 2026 | 36.65% | 5 January 2026 | View the January 2026 update |
Pace Analysis
How Fast Golf Hillside Has Been Built
With two dated inspections on record, the honest reading is the most recent cycle set against the whole-build average since groundbreaking:
- Oct 2024 groundbreaking to Apr 2026: whole-build average to 54.66%About 3.0 points per month
- Jan 2026 to Apr 2026: superstructure and envelope, 36.65% to 54.66%About 5.2 points per month
The two figures tell the real story. Averaged across the whole build since the 16 October 2024 start, Golf Hillside has moved at roughly three points a month, but the January-to-April 2026 cycle ran at closer to five, an acceleration that lines up with the tower entering active superstructure work. An undated earlier register reading of 23.97% and the 12.68 point step up to January's 36.65% sit before that window; without a published date they stay in the narrative rather than the pace math. For a buyer, a mid-build project speeding up as it clears its foundations and starts rising floor by floor is the pace shape you want to see, and the April RERA note confirms external envelope and MEP works are now underway alongside the structure.
Get the Next Inspection Figure First
Tell me you are tracking Golf Hillside and I will send you the next recorded figure and site photos directly, ahead of the page update.
Get the Next Update on WhatsAppProject Profile
About Golf Hillside at Dubai Hills Estate
The build percentage only matters in the context of what is being delivered. The full project guide covers what buyers are tracking toward on this page:
Golf Hillside Project Guide
Layouts across 184 one, two, and three bedroom residences over twenty storeys, the golf-course frontage, the amenity podium, and the full investment case behind Emaar's Dubai Hills Estate tower.
View the Golf Hillside Project GuideEntering Golf Hillside Mid-Build?
Golf Hillside runs on a construction-linked payment plan, so entering at this stage means your installments track certified progress from 54.66% onward. If the record on this page is what brought you here, ask me for current availability before the next milestone shifts it.
Ask About Current Availability on WhatsAppStage Record
Golf Hillside Build Stages, Mapped to the Inspections
Rather than a generic construction sequence, each stage below is anchored to the inspection window it actually occupied in this project's record, so you can see where Golf Hillside sits today and what comes next.
Site Activation and Groundworks
From the 16 October 2024 construction start: enabling, piling, foundation, and substructure works on plot 5366, all confirmed complete in the April 2026 RERA report.
Substructure to Podium
Basement, ground, and podium structure taking shape as the register readings climbed toward 36.65% at the 5 January 2026 inspection.
Superstructure Rising

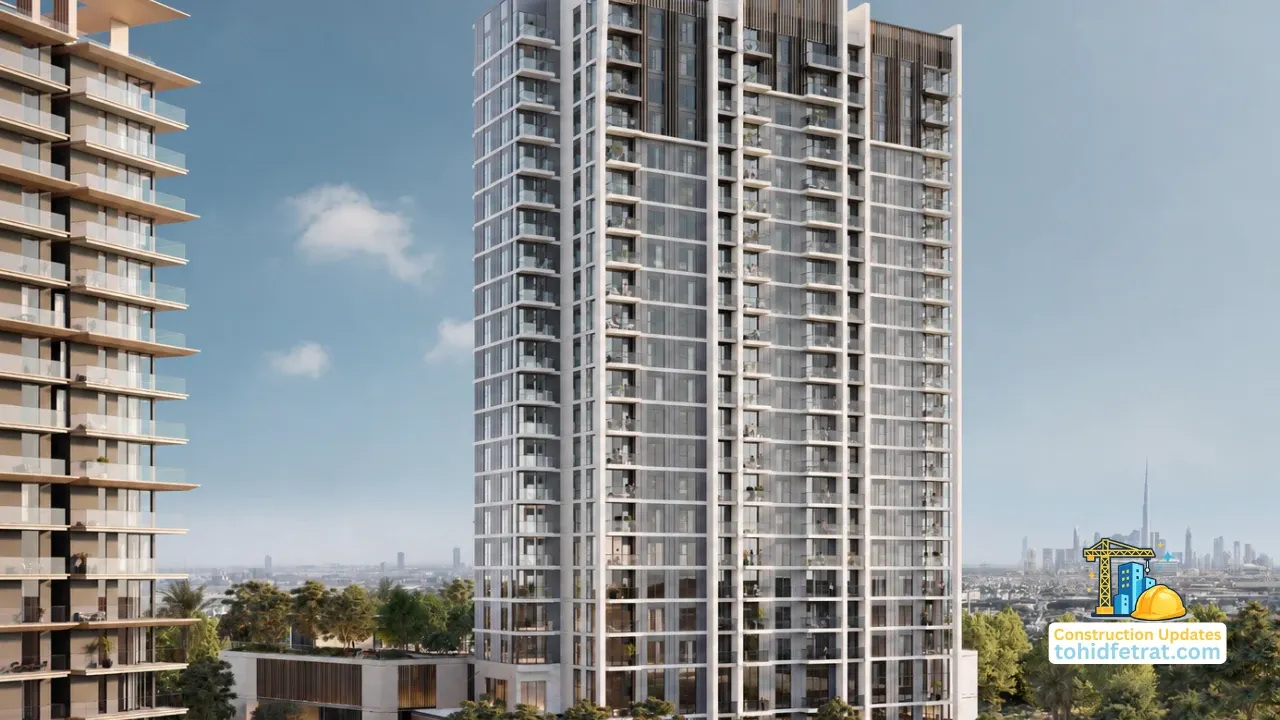

The tower rising floor by floor through its twenty storeys, from 36.65% on 5 January to 54.66% on 21 April 2026, with external envelope and MEP works now active.
Envelope, MEP, and Internal Fit-Out
Ahead of the current reading: facade installation, mechanical, electrical, and plumbing systems, and internal finishes on completed floors as the tower is enclosed.
Commissioning and Handover
Final testing, systems commissioning, and the completion certificate toward the 31 December 2028 DLD completion date and handover.
What each construction stage involves in general is covered once in the guides on the Dubai Construction Updates hub, so this page stays focused on Golf Hillside's own record.
Buyer Position
Tracking Your Position at Golf Hillside
This page is one of four project resources that together cover a Golf Hillside purchase from payment protection to residency to handover. You are on the construction record; the siblings sit one click away:

Golf Hillside Construction Updates
This page: the verified inspection record for Golf Hillside, from the October 2024 groundbreaking toward handover.
Golf Hillside Golden Visa
Check whether a qualifying Golf Hillside purchase supports ten year UAE Golden Visa residency eligibility.
Read the Golf Hillside Golden Visa Guide
Golf Hillside Escrow Account
Verify project 3237's DLD-registered escrow account at Mashreq Bank and how installments track certified milestones.
Verify the Golf Hillside Escrow Account
Golf Hillside Snagging Inspection
Plan independent defect documentation now so snagging is booked before your Golf Hillside handover inspection.
Plan Golf Hillside SnaggingApproaching the Next Milestones
Between 54.66% and Handover: What Golf Hillside Buyers Should Do Now
At just over the halfway mark, the useful work for a Golf Hillside buyer is not handover preparation yet but staying aligned with the construction-linked payment plan, where each recorded milestone releases the next installment. The three steps below keep your position tracking the verified record rather than a sales schedule.
First, confirm your remaining installments against the certified milestones on the Golf Hillside escrow account page, since at 54.66% the 40% completion trigger has passed and the 60% trigger is next.
Second, follow the inspection record cycle by cycle here and in the linked monthly updates, so each new RERA figure, rather than a marketing estimate, is what tells you where the tower actually stands.
Third, if your purchase may support residency, understand the eligibility path early through the Golf Hillside Golden Visa guide, because the qualifying thresholds and title timing shape when you can apply.
Send me your unit number on WhatsApp and I will tell you what the April inspection means for your position and map the milestone sequence for your specific unit.
The Wider Picture
Explore Dubai Hills Estate
A build record is only half the picture; the other half is what is rising around it. These three pages put Golf Hillside's progress in its community and developer context:
Dubai Hills Estate Properties for Sale
Browse apartments and villas delivering across Dubai Hills Estate as Golf Hillside rises on plot 5366.
See Dubai Hills Estate Properties for Sale
Dubai Hills Estate Community Overview
See how the golf course, parks, and Dubai Hills Mall frame the district around Golf Hillside.
Explore the Dubai Hills Estate Community
Emaar Properties Developer Profile
Review Emaar's 115,000 delivered residences and track record before Golf Hillside reaches its 2028 handover.
View the Emaar Developer ProfileConstruction tracking for other Dubai projects is indexed on the Dubai Construction Updates hub.
FAQs
Golf Hillside Construction Updates Frequently Asked Questions
Golf Hillside is an active DLD-registered project (number 3237) in its superstructure and envelope phase, recorded at 54.66% at the inspection of 21 April 2026. The full record is in the inspection timeline above.
The 21 April 2026 inspection recorded 54.66% construction progress, up 18.01 points from the 36.65% reading of 5 January 2026. The full site report is in the April 2026 construction update.
The DLD-registered completion date for project 3237 is 31 December 2028, placing handover in the fourth quarter of 2028. With the 21 April 2026 inspection at 54.66%, roughly 45 points of progress remain, and this page updates as each new inspection is recorded.
The project is a single twenty storey tower of 184 residential units across one, two, and three bedroom apartments, with a total built-up area of 20,017.71 sq m on plot 5366 within Dubai Hills Estate.
Across the whole build since the 16 October 2024 start, progress has averaged about 3.0 percentage points per month to reach 54.66% by April 2026. The most recent cycle ran faster, at about 5.2 points per month between the 5 January and 21 April 2026 inspections. The full breakdown is in the pace analysis above.
Construction officially started on 16 October 2024. By the 5 January 2026 inspection the tower had reached 36.65%, with enabling, piling, foundation, and substructure works complete; that reading is documented in the January 2026 construction update.
Yes. The twenty storey tower sits in the golf district of Dubai Hills Estate, with apartments oriented toward the Dubai Hills Golf Course and the low-rise villa communities beyond. Layouts and views are covered in the Golf Hillside project guide.
Emaar construction-linked plans tie installments to completion levels, so at a verified 54.66% the 40% completion milestone has already passed and the 60% milestone is the next trigger to plan for. The registered escrow account for project 3237, held at Mashreq Bank, is set out on the Golf Hillside escrow verification guide.

Your Advisor
Tohid Fetrat
Independent of the developer: I work for the buyer, and my only job on this page is keeping the Golf Hillside construction record accurate, inspection by inspection, until handover, walking the site personally each inspection period. Client identities and transactions are never published or referenced. Message or call me directly: you will always reach me personally, never a call center or sales team.
Ask your question, get your answer. No obligation and no follow-up unless you ask for it.
