Select Group · Business Bay
The Edge by Select Group Construction Updates
Twin-Tower Progress on the Business Bay Canal, Verified Inspection by Inspection
The Edge reached 88.86% construction at its 23 April 2026 RERA inspection, with finishing works now separating Select Group's Business Bay twin towers from Dubai Canal handover.
Construction tracking against RERA inspection data, updated after every recorded inspection.
Direct advisor access. Every message answered personally, never by a call center.
Construction Snapshot
The Edge by Select Group at a Glance
The Edge is Select Group's 1,030-residence twin-tower development on the Business Bay stretch of Dubai Canal, built for the affordable end of a district where most new stock opens far higher. Just under three years separate its 09 June 2023 construction start from the 88.86% recorded at the April 2026 inspection, and the figures below are the DLD-registered anchors behind that record. A 65,564.27 sq m built-up area across 1,030 units is a compact footprint, the efficient-layout signature of a project designed for a dense central plot rather than sprawling canal frontage.
2611
Active
09 June 2023
1,030 residential units
65,564.27 sq m
11 October 2026 (DLD)
Figures from Dubai Land Department registration records, updated after each recorded inspection. How every project on this site is tracked is explained once on the Dubai Construction Updates hub.
Inspection Record
The Edge by Select Group Construction Update Timeline
Two RERA inspections carry published dates on this record: 42.01% logged in June 2025, with the twin towers mid-rise, and 88.86% in April 2026, with the envelope closing and finishing underway. Each dot on the track below marks one of those dated inspections, and each table row links its full monthly update with site photographs.
| Inspection Month | Construction Progress | Inspection Date | Full Update |
|---|---|---|---|
| April 2026 | 88.86% | 23 April 2026 | View the April 2026 update |
| June 2025 | 42.01% | 11 June 2025 | View the June 2025 update |
Pace Analysis
How Fast The Edge by Select Group Has Been Built
Reading the pace across the record tells buyers more than any single percentage. Anchored to The Edge's June 2023 start and its two dated inspections, the build splits into two clear phases:
- Jun 2023 start to Jun 2025 inspection: groundworks and superstructure, 0% to 42.01%About 1.7 points per month
- Jun 2025 to Apr 2026: facade, MEP, and fit-out, 42.01% to 88.86%About 4.5 points per month
The shape of that curve is what an experienced eye looks for. The first two years ran at a measured pace while enabling, foundation, and substructure works were completed and the twin towers began rising, the stage that always moves the percentage slowly. Progress then more than doubled its rate once the structure was up and facade, MEP, and internal finishing could run in parallel across both towers, carrying the reading to 88.86% by 23 April 2026. That April figure sits in the finishing band, where the remaining points come from commissioning and approvals rather than visible construction, and the DLD expected completion of 11 October 2026 is the window this phase is closing toward. For an investor weighing exit timing or an end user planning their move, a near-90% project moving into commissioning is the profile you want at this point in the record.
Get the Next Inspection Figure First
Tell me you are tracking The Edge by Select Group and I will send you the next recorded figure and site photos directly, ahead of the page update.
Get the Next Update on WhatsAppProject Profile
About The Edge by Select Group at Business Bay
The build percentage only matters in the context of what is being delivered. The full project guide covers what buyers are tracking toward on this page:
The Edge by Select Group Project Guide
Compact 1 and 2 bedroom layouts across 1,030 twin-tower residences, amenities, the canal-front Business Bay position, and the full investment case behind Select Group's entry-priced development.
View The Edge Project GuideConsidering a Near-Handover Entry?
Availability at The Edge continues to shift as the towers approach completion. If the record on this page is what brought you here, ask me for current availability before remaining inventory narrows further.
Ask About Remaining Availability on WhatsAppStage Record
The Edge by Select Group Build Stages, Mapped to the Inspections
Rather than a generic construction sequence, each stage below is anchored to the window it actually occupied in this project's record, so you can see when The Edge passed through it against its two dated inspections.
Site Activation and Groundworks
From the 09 June 2023 construction start: enabling works and site preparation on the canal-front Business Bay plot ahead of foundation and substructure.
Foundation and Substructure
Foundation and substructure completed below grade, the base that carries both towers across the 65,564.27 sq m built-up footprint, confirmed complete in later inspection findings.
Twin-Tower Superstructure
Floor plates and cores rose across both residential towers until the 11 June 2025 inspection recorded 42.01%, with superstructure and early facade activity underway.
Facade, MEP, and Fit-Out
The fastest phase: nearly 47 points as the envelope was installed and MEP systems and internal finishes advanced, reaching 88.86% by 23 April 2026.
Finishing, Commissioning, and Delivery
Internal finishing, building systems commissioning, and final external works toward the 11 October 2026 expected completion, recorded at 88.86% on 23 April 2026.
What each construction stage involves in general is covered once in the guides on the Dubai Construction Updates hub, so this page stays focused on The Edge's own record.
On-Site Documentation

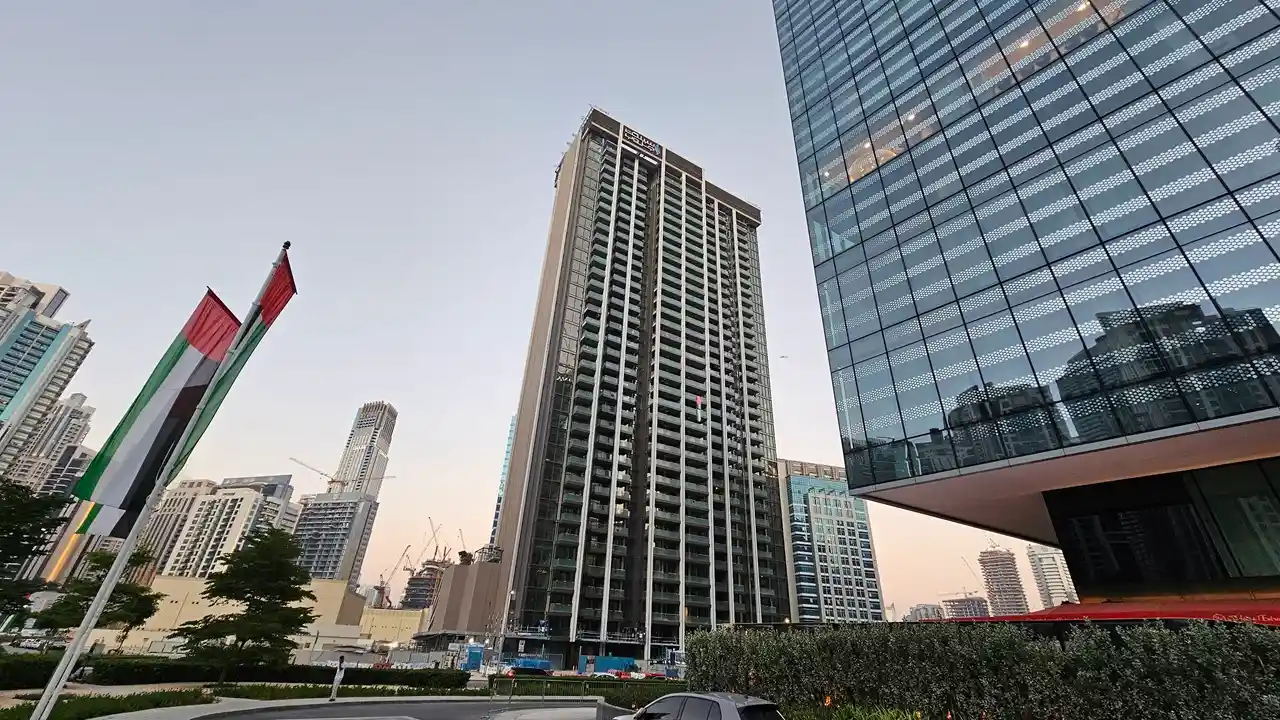

The Edge by Select Group Construction Gallery

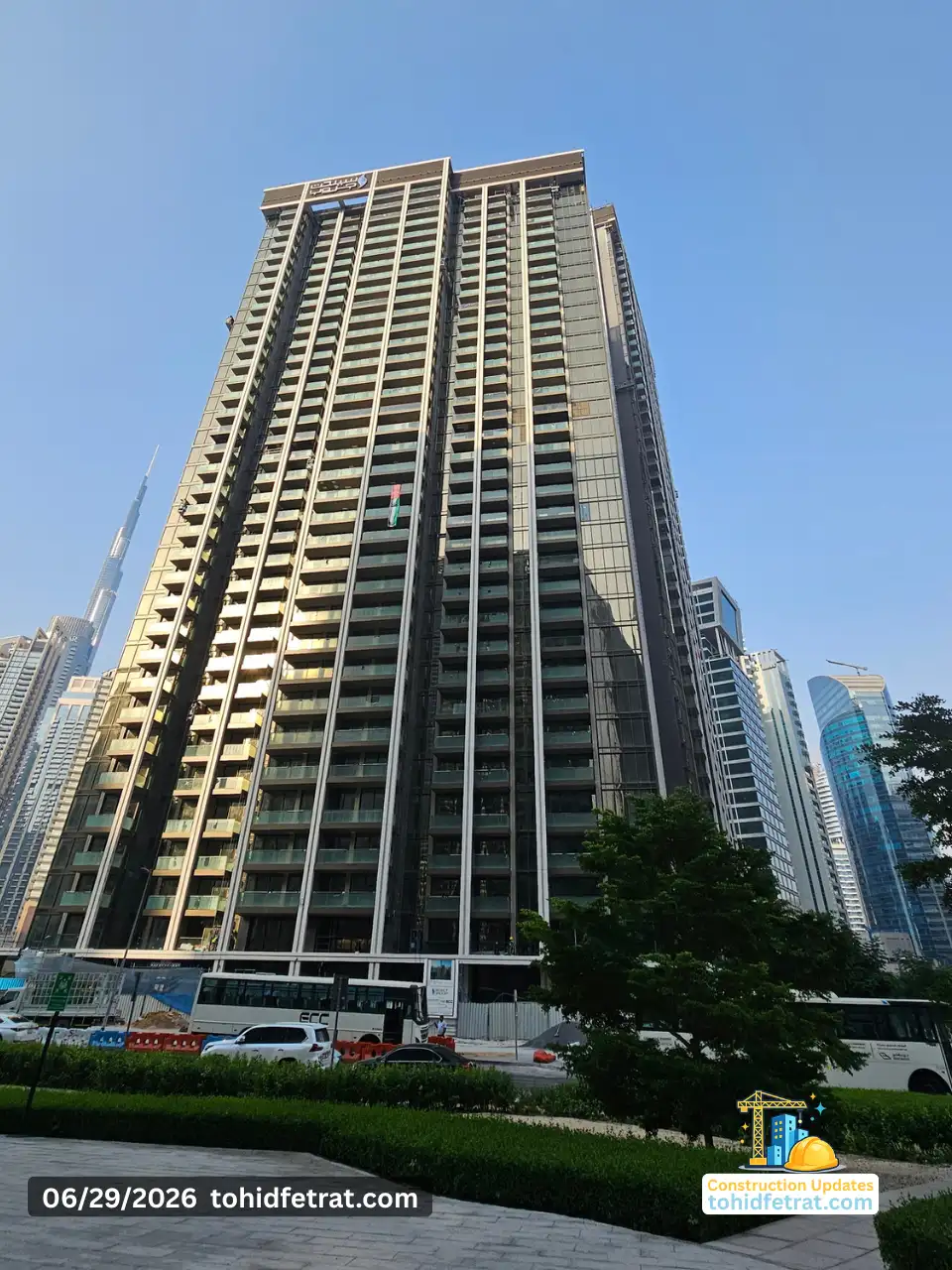

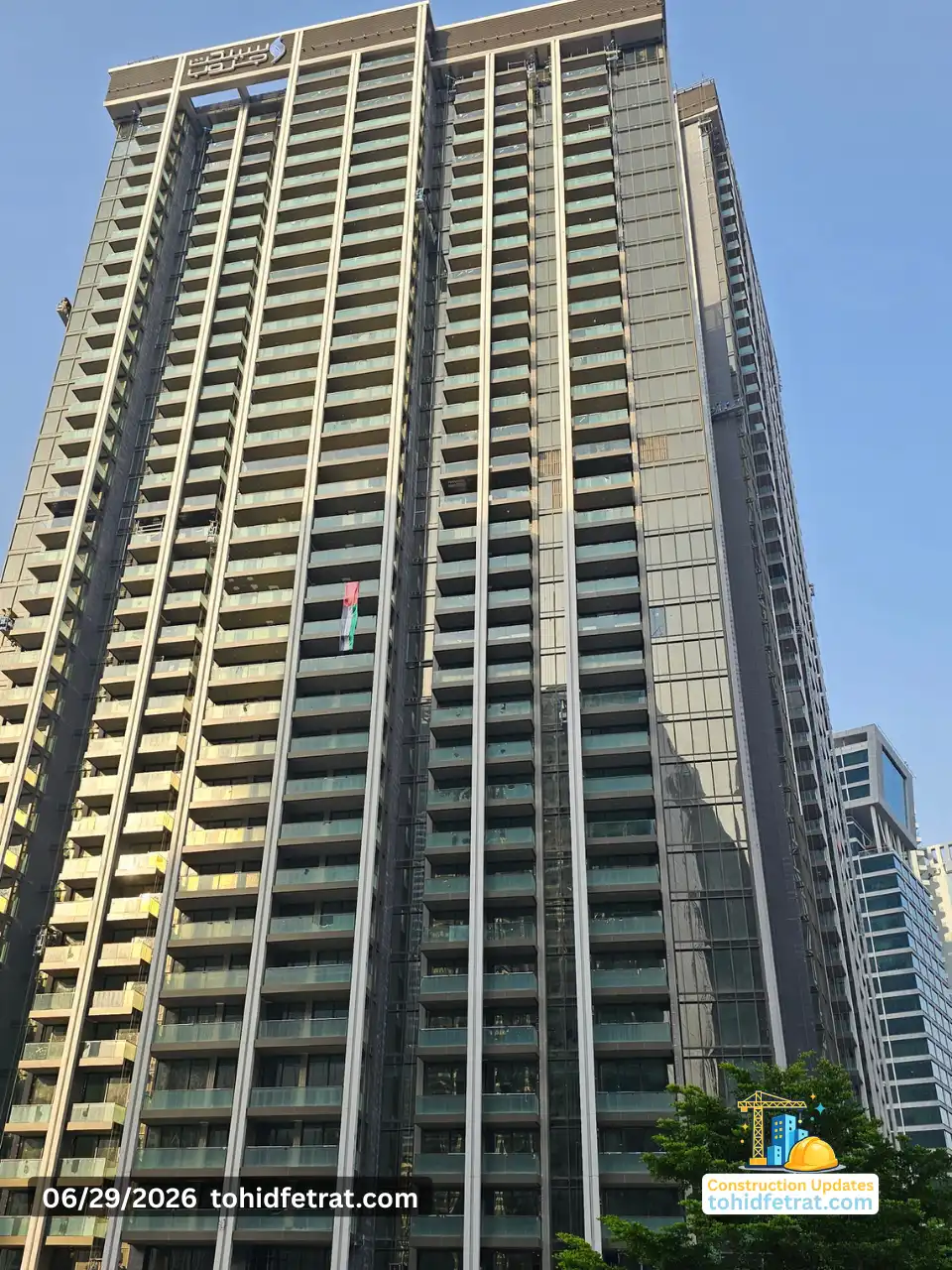

The most recent site visit, on 29 June 2026, shows the twin residential towers reading as near-complete architecture on the Business Bay canal frontage, with the exterior envelope in place. Most images are captured by Tohid Fetrat on site; the three below are representative, and each period's full photo set lives in its monthly update. Tap any image to view it in full.



Photos of Your Side of the Tower
I walk The Edge site personally each inspection period. If you own a unit here, tell me your tower side or the angle you want and I will capture it on my next visit and send it to you directly.
Request My Tower-Side Photos on WhatsAppFull photo sets for each period are published inside the monthly updates linked in the timeline above.
Buyer Position
Tracking Your Position at The Edge by Select Group
This page is one of four project resources that together cover a purchase at The Edge from payment protection to residency to handover. You are on the construction record; the siblings sit one click away:

The Edge Construction Updates
This page: the verified inspection record for The Edge by Select Group, from groundbreaking to handover.
The Edge Golden Visa
The Edge unit tiers meeting the AED 2M threshold unlock 10-year UAE Golden Visa eligibility.
Read The Edge Golden Visa Guide
The Edge Escrow Account
Verify The Edge's DLD-registered escrow account and how each installment releases against certified construction milestones.
Verify The Edge Escrow Account
The Edge Snagging Inspection
At 88.86% recorded progress, arrange independent defect documentation before you accept your residence at handover.
Book The Edge SnaggingApproaching Handover
Between 88.86% and Handover: What The Edge Buyers Should Do Now
The gap between the April reading and 100% is closed by commissioning, approvals, and final works rather than visible construction, which makes this the window where buyer preparation matters most. Handover notices at comparable projects typically give buyers a short window to complete their appointment, so the three steps below happen now, not when the notice arrives.
First, arrange independent snagging so defects in your residence are documented before you accept it; the The Edge snagging page covers timing and what gets inspected.
Second, confirm your remaining installments against the certified milestones on the The Edge escrow account page so final payments track verified progress, not requests, especially under the 30/70 plan where the larger share falls due at completion.
Third, if your purchase may qualify for residency, settle eligibility before handover through the The Edge Golden Visa guide, since the title deed timing affects the application path.
Send me your unit number on WhatsApp and I will tell you what the April inspection means for your handover and map the sequence for your specific unit.
The Wider Picture
Explore The Edge Structure
A build record is only half the picture; the other half is what is rising around it. These three pages put The Edge's progress in its district, community, and developer context:
Business Bay Apartments for Sale
Compare canal-front towers and delivering apartments across Business Bay against the entry-priced position The Edge holds.
See Business Bay Properties for Sale
Business Bay Community Overview
Dubai Canal infrastructure and Downtown connectivity are reshaping Business Bay around The Edge as it completes.
Explore the Business Bay Community
Select Group Developer Profile
Review Select Group's completed Dubai towers and delivery record as The Edge enters its finishing phase.
View the Select Group Developer ProfileConstruction tracking for other Dubai projects is indexed on the Dubai Construction Updates hub.
FAQs
The Edge by Select Group Construction Updates Frequently Asked Questions
The Edge by Select Group is an active DLD-registered project (number 2611) in its finishing and commissioning phase, recorded at 88.86% at the inspection of 23 April 2026. The full record is in the inspection timeline above.
The 23 April 2026 inspection recorded 88.86% construction progress, up 46.85 points from the 42.01% logged at the June 2025 inspection. The full site report and photographs are in the April 2026 construction update.
From the 09 June 2023 start to the June 2025 inspection, progress averaged about 1.7 percentage points per month to reach 42.01%, then more than doubled to about 4.5 points per month through facade, MEP, and fit-out, reaching 88.86% by 23 April 2026. The full breakdown is in the pace analysis above.
The DLD-registered expected completion for project 2611 is 11 October 2026, and the latest inspection on 23 April 2026 recorded 88.86% progress, placing the towers in their final delivery phase. Select Group's marketed handover guidance is Q3 2026; actual handover is confirmed as final inspections complete, and this page's record is updated when the closing inspection is recorded.
DLD registration records show 1,030 residential units across compact 1 and 2 bedroom apartments, with a total built-up area of 65,564.27 sq m, an efficient footprint for a twin-tower project on a central Business Bay plot.
Construction officially started on 09 June 2023. The first inspection carrying a published date, 11 June 2025, recorded 42.01% progress; that reading is documented in the June 2025 construction update.
Yes. The development's twin towers sit on the Business Bay stretch of Dubai Canal, with canal-facing and skyline-facing 1 and 2 bedroom apartments near Downtown Dubai. Layouts and the investment case are in The Edge by Select Group project guide.
With the towers at 88.86%, buyers should arrange independent snagging at The Edge around their handover appointment, confirm remaining installments against certified milestones on The Edge by Select Group's escrow account page, and settle any residency questions via The Edge by Select Group's Golden Visa guide before the title deed is issued.

Your Advisor
Tohid Fetrat
Independent of the developer: I work for the buyer, and my only job on this page is keeping The Edge by Select Group's construction record accurate, inspection by inspection, until handover, walking the site personally each inspection period. Client identities and transactions are never published or referenced. Message or call me directly: you will always reach me personally, never a call center or sales team.
Ask your question, get your answer. No obligation and no follow-up unless you ask for it.
