VELA by OMNIYAT: Six Readings on the Marasi Bay Basin
VELA by OMNIYAT, a 38-residence tower on the Marasi Bay basin, rose from 28.76% to 50.03% between March and September 2026.

Verified Project Progress, RERA Inspections, and Handover Timelines Across the Marasi Bay Waterfront

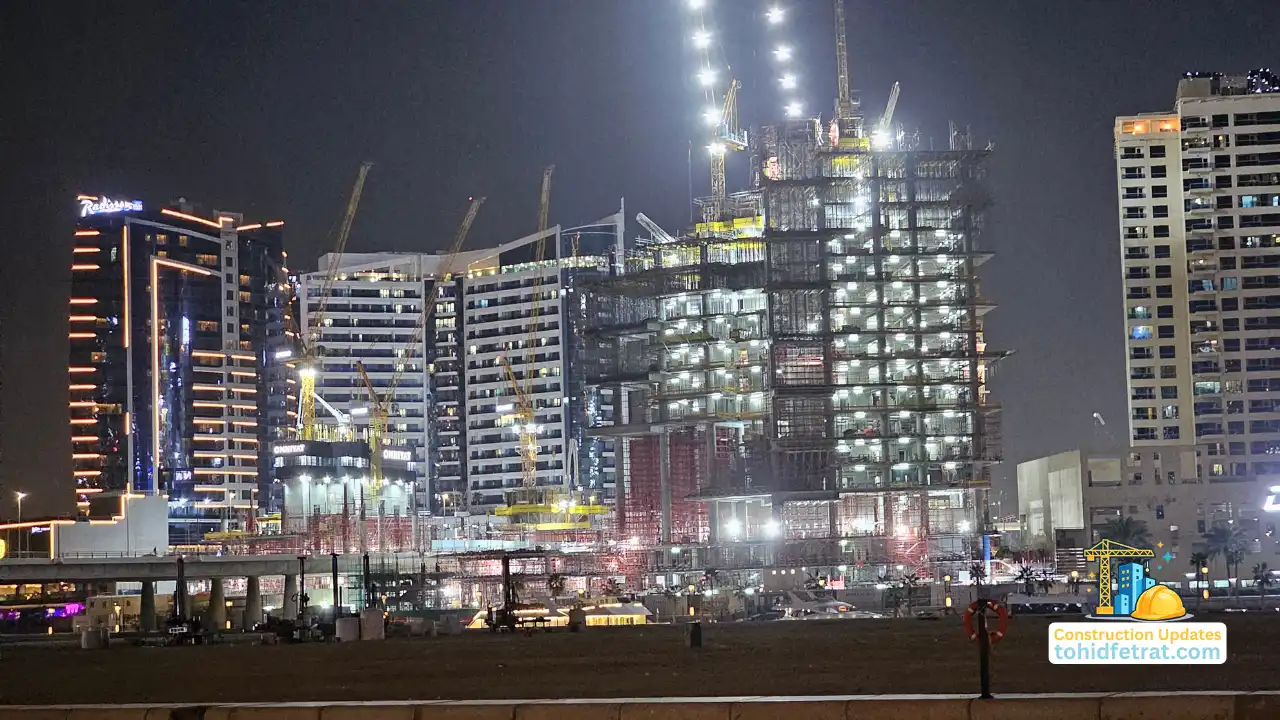

Marasi Bay construction updates cover the waterfront basin of Business Bay at the head of the Dubai Water Canal, where branded residences, offices and hospitality towers are rising around the marina. What deserves attention is the gap between inspections: steady gains from one RERA reading to the next tell a buyer more about handover than any launch date.
Each card follows a Marasi Bay tower measured against its own RERA inspection record rather than the developer’s marketing calendar. Read the inspection date beside the percentage: a recent reading tells you where the site stands today, while an old one only tells you where it stood.

VELA by OMNIYAT, a 38-residence tower on the Marasi Bay basin, rose from 28.76% to 50.03% between March and September 2026.

HQ by Rove, IRTH's 414-office tower on plot 107 in Marasi Bay, stood at 0.7% at the 6 July 2026 inspection.

ENARA by OMNIYAT, a 49-unit office tower on plot 113 where Dubai Canal meets Marasi Bay, held 7.25% in June 2026.

I am Tohid Fetrat, a Dubai luxury real estate advisor based at The Opus by Omniyat in Business Bay. My office is inside this district, these are the cranes outside my window, and every update on this page comes from data I personally verify before publishing.
Each Marasi Bay project in this directory links to its full construction report, with progress, the latest RERA inspection date and the expected completion in one row. Read the rows together rather than one at a time: towers sharing one waterfront, and often one developer, make a slipping schedule easy to spot.
| Project | Progress | Inspection | Completion | Report |
|---|---|---|---|---|
| VELA | 50.03% | 10 September 2026 | Q4 2027 | View ReportAsk |
| HQ by Rove | 0.7% | 6 July 2026 | Q1 2029 | View ReportAsk |
| ENARA by OMNIYAT | 7.25% | 12 June 2026 | Q4 2028 | View ReportAsk |
| VELA Viento | 21.81% | 18 May 2026 | Q3 2027 | View ReportAsk |
| The Lana Residences | 100% | 11 January 2024 | Ready | View ReportAsk |
Progress figures reflect official RERA project inspection data.
Following a project on this page? Just reply with a project name and I will send you the verified progress and inspection updates directly on WhatsApp as they are published.
Get My Project Updates on WhatsAppMarasi Bay towers pass through seven broad stages between site preparation and handover. The early ones often look slow on paper: shoring, piling and deep basements absorb months of work before the first floors appear above ground.
The plot is cleared, the contractor mobilizes and authority approvals are secured, with waterfront utilities planned before any structure begins. The date to note is the registered construction start, because every later inspection is measured from it.
Shoring, piling and basement excavation take the site below ground, and progress figures can stay in single digits for months. That is normal at this stage; the signal is each new inspection recording the next piece of foundation work as complete.
Concrete cores, slabs and podium levels rise floor by floor, and this is often where the percentage starts climbing fastest. A steady gain between readings here is the clearest sign that the main contract is properly resourced.
Curtain wall, glazing and balconies close the building against the weather, and on the waterfront the façade defines how the tower reads from the marina. The signal is the envelope moving up the tower soon after the structure, rather than waiting for the frame to finish.
MEP services, interiors and building systems are installed, and in high specification residences the finishing scope is extensive. Progress can slow here even on a healthy site, so the spacing between inspections matters more than the headline percentage.
Promenades, landscaping, marina access and road connections are completed around the towers. These shared areas deserve the same attention as the building, because a finished tower beside an unfinished waterfront is not yet a finished address.
Authority inspections, testing and commissioning lead to the completion certificate and the handover schedule. This is the window for a professional snagging inspection, while the developer is still responsible for fixing what is found.
Most buyer disputes start between stages, not at handover. Knowing which stage your project is in is what makes an inspection worth booking.
Not sure which stage your project is in?
Check My Project Stage on WhatsAppMarasi Bay trades on position rather than volume: a defined waterfront basin where much of the supply sits at the ultra luxury end, so each month of delay carries real weight. For an end user, construction updates show when a residence or office will genuinely be ready; for an investor, they show when capital stops waiting and starts working.

Tracking progress is only one part of protecting an off plan purchase. These are the three areas buyers ask me to manage most.
Confirm your payments flow into the project’s registered escrow account, not anywhere else.
Ask About EscrowPlan a professional snagging inspection before you sign for handover.
Ask About SnaggingGet the latest inspection data on your project as it is published.
Ask About HandoverReview verified Marasi Bay construction update locations across luxury towers, canal facing developments, branded residences, mixed use skyscrapers, and active off plan projects connected to ongoing inspection activity and urban infrastructure growth throughout Dubai.

Marasi Bay grows through position rather than scale: a marina basin on the Business Bay waterfront, close to Downtown Dubai, where developers keep adding branded residences, offices and hospitality. My read is that the address speaks for itself, so the open question for any buyer is delivery, which is exactly what these updates measure.

Marasi Bay construction updates are progress records for the towers rising on the Business Bay waterfront, based on official RERA inspection data. Each update states the recorded percentage, the inspection date and the expected completion, so progress can be judged on evidence rather than on launch material.
Investors follow Marasi Bay construction activity because delivery timing shapes both the holding period and the exit. A tower that keeps a steady pace between inspections supports a realistic handover plan, while one that stalls can push back rental income, resale timing and final payments.
Marasi Bay construction updates cover the active projects around the marina basin, including branded residences, ultra luxury apartment towers, office towers and hospitality developments. The mix matters, because an office tower and a branded residence follow different finishing schedules even when they share a waterfront.
Marasi Bay construction reports are refreshed as new RERA inspection readings are recorded, which for an active tower typically means a new figure every few months. The date beside each figure matters as much as the figure itself, since an older reading may no longer reflect the site.
Yes. Comparing several Marasi Bay projects shows how consistently each developer moves from foundations to handover and whether its schedules hold. Because many towers in the district share a waterfront setting and a similar luxury specification, differences in pace tend to reflect execution rather than location.
A Marasi Bay construction report typically includes the RERA progress percentage, the inspection date, the current construction stage, the registered completion date and the record of earlier readings. Read together, these show both where a tower stands and how quickly it has been moving.
